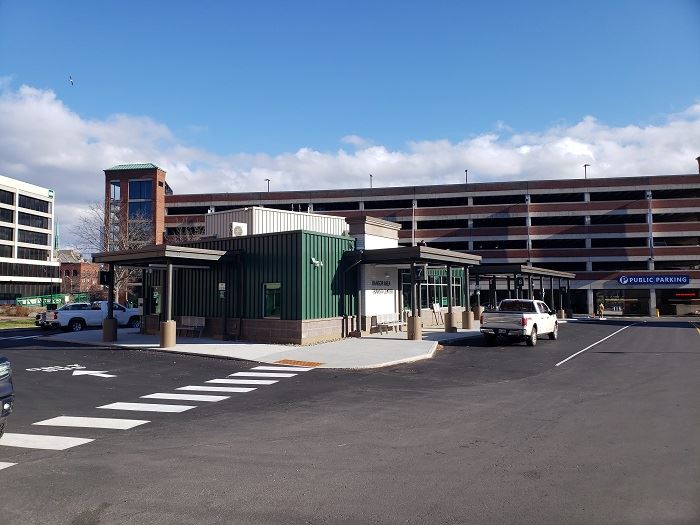

Bangor Transit Center

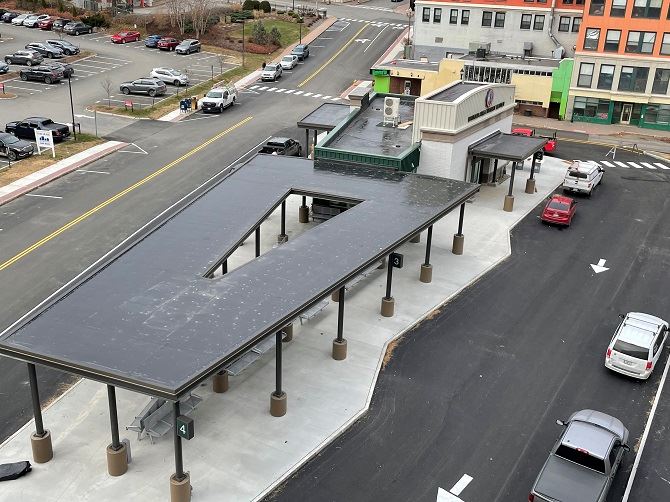

Transit CenterDecember 6, 2022

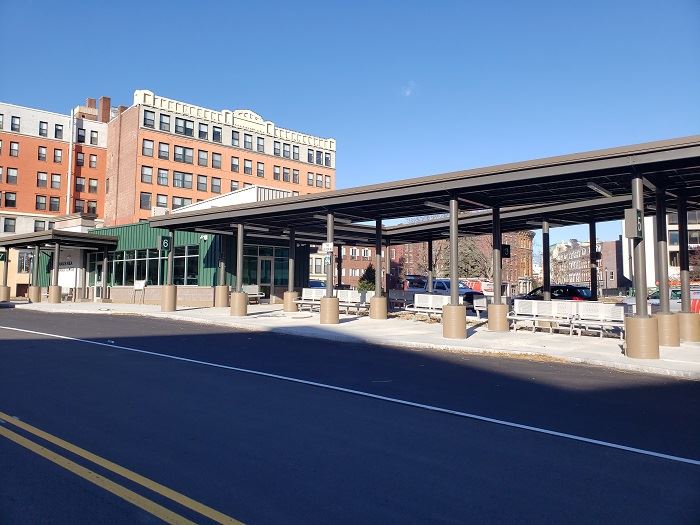

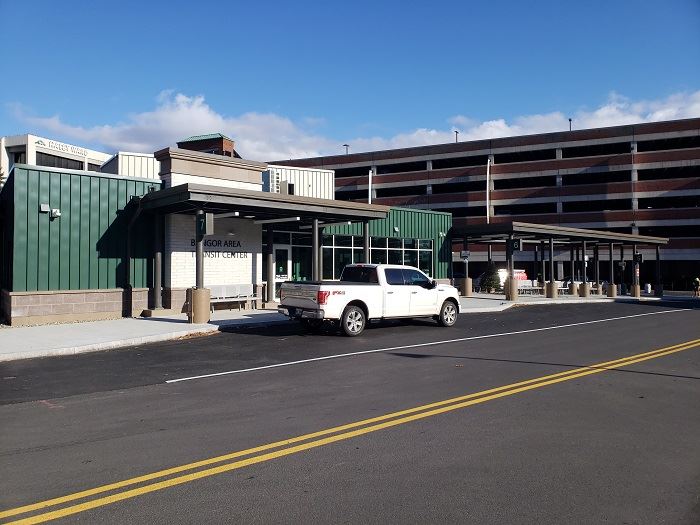

After 14 months of construction, the Bangor Area Transit Center has been completed and is ready to serve members of the community for their transportation needs. This building replaces the former bus depot at the Pickering Square Parking Garage and includes an updated facility for both riders of the Community Connector and City transit drivers.

The new location will provide continued services to Bangor, Brewer, Orono, Hampden, Old Town, Veazie, and the University of Maine.

The City of Bangor would like to thank Benchmark (General Contractor) for their continued support, diligence, and attention to detail during the entirety of this project. The City would also like to thank Artifex (Architect) for their support and assistance throughout the project as well.

The City of Bangor's Community Connector is hosting a Grand Opening Ceremony at the Bangor Area Transit Center, 25 Water Street, on Friday, December 9, 2022, at 1 pm

Services are expected to remain at Broad Street Park until Wednesday, December 14, 2022, as the contractors work to finish any outstanding items to ensure a completed facility for bus patrons.

Transit Center

Transit Center

Transit Center

Friday, December 2, 2022

Transit Center

Transit Center

Friday, October 14, 2022

Transit Center

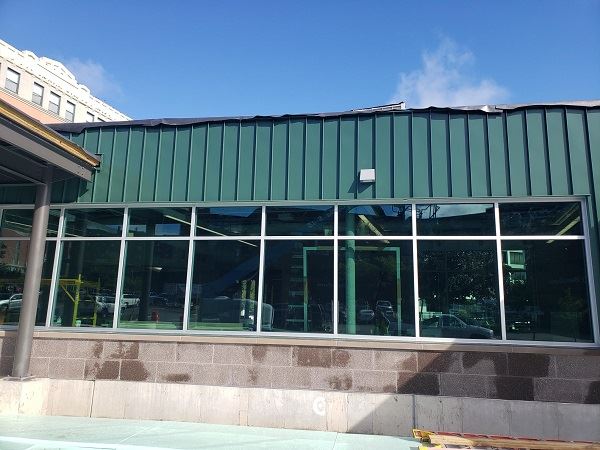

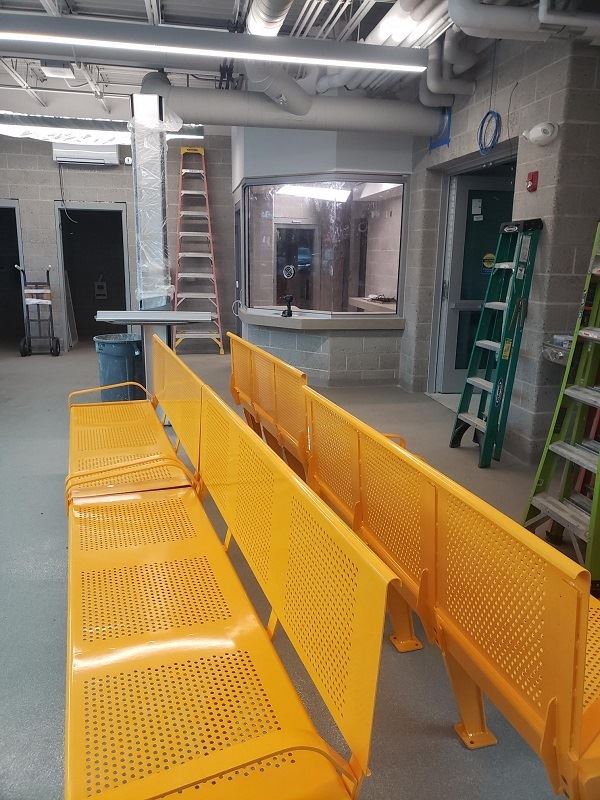

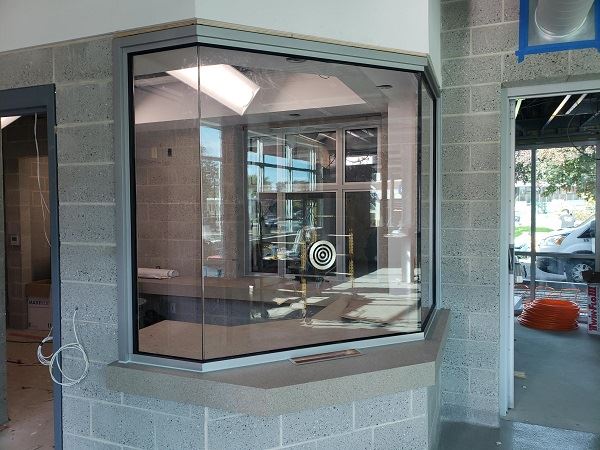

O&P Glass installed new glass in the teller area this week.

Transit Center

Benches are being installed in the waiting area.

The perimeter concrete slab is slated to be poured next week along with remaining pavement around the transit center.

Cabinets and countertops have been installed in the break area for the staff.

Friday, October 7, 2022

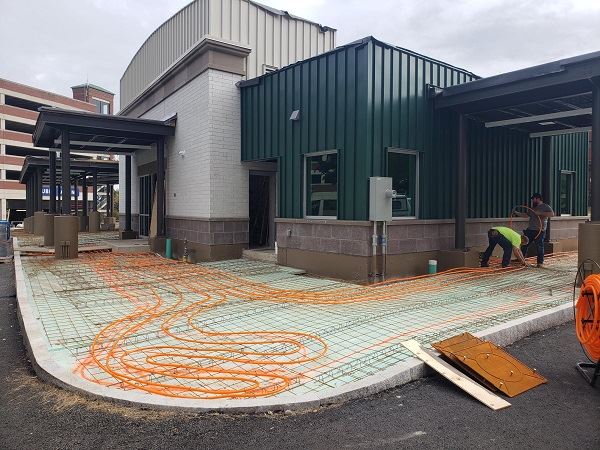

Granite Corp installed radiant heat loops this week in preparation for concrete pours next week.

Transit Center

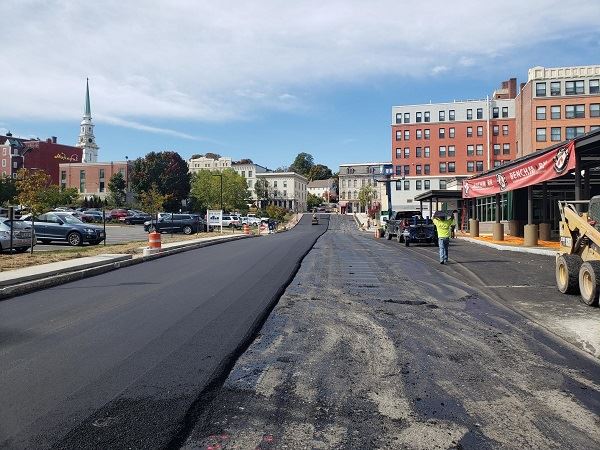

Eastwood Contractors laid the final wearing course on Water Street.

Transit Center

Countertops are being installed, as well as other appliances in the building.

Friday, September 23, 2022

Transit Center

Storefront glass for the transit center has been installed, and entrance door and glass installation started this week.

Transit Center

Granite Corp installed the water meter for the building this week. They also began installation of heat pumps.

Friday, September 9, 2022

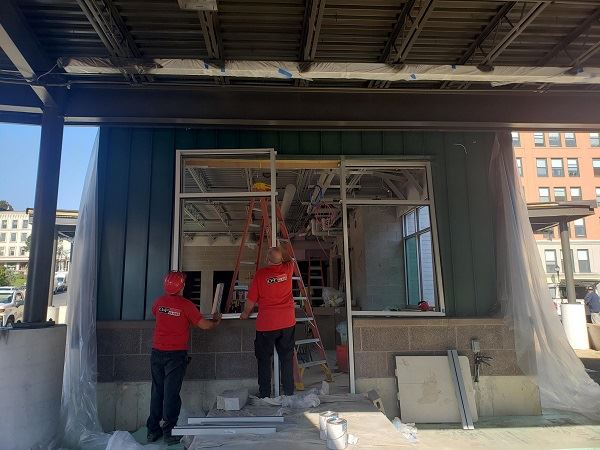

O&P Glass began installing g storefront windows of the Transit Center earlier this week. They hope to be done by next week.

Transit Center

Granite Corp has been working on installation of heat and air handling exchange units on the roof, before moving to radian heat installation around perimeter of building.

Transit Center

C&C Lynch completed rehab of the old bus route, by loaming and seeding a new pocket park area adjacent to the Transit Center.

Friday, September 2, 2022

Street's Pavement and Striping paved the area around the Transit Center today

Epoxy flooring has been installed inside the building.

Transit Center

There is now power to the building, and lighting is being installed around the outside of the Transit Center.

Storefront windows are slated for installation at the beginning of next week.

Friday, August 26, 2022

C&C Lynch began fine-grading the road around the transit center this week in preparation for pavement next week.

Transit Center

Painters have begun painting interior of the building, with some remaining work outside.

Epoxy flooring is scheduled to begin next week, along with remaining brick work inside the building.

Friday, August 19, 2022

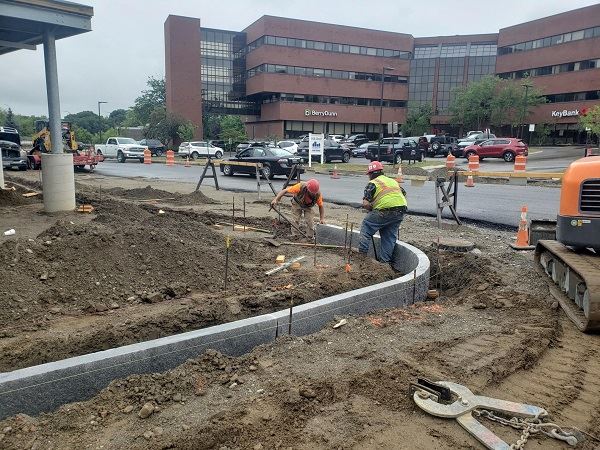

Dirigo Slipform installed granite curbing around the transit center this week.

Transit Center

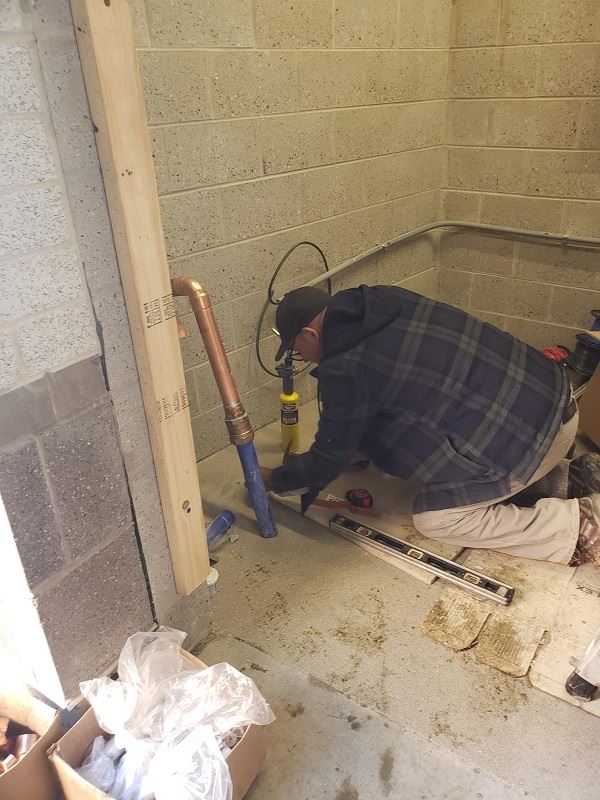

Interior work continues with installation of plumbing, electrical, heating and ventilation components.

Friday, August 12, 2022

Transit Center

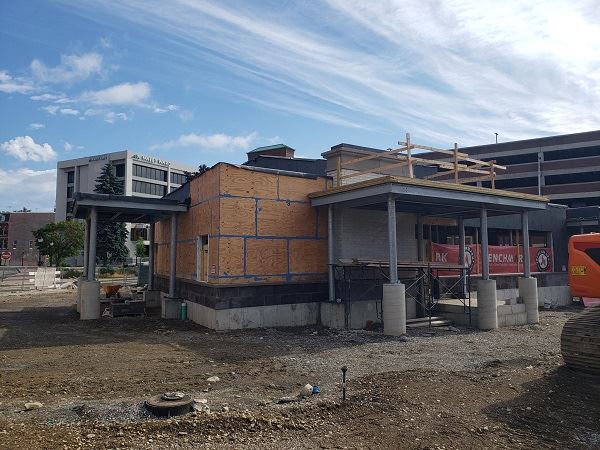

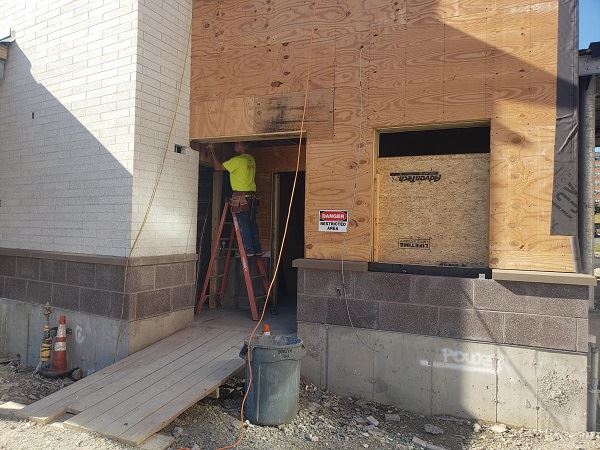

Exterior siding is almost complete, with remaining portion on the roof by the mechanical room.

Transit Center

C&C Lynch began placing material on the adjacent area toward the pocket park between Haley Ward and the Parking garage for future Greenspan.

Transit Center

Painters continue to paint columns and exposed steel, as well as interior of the building

Friday, August 5, 2022

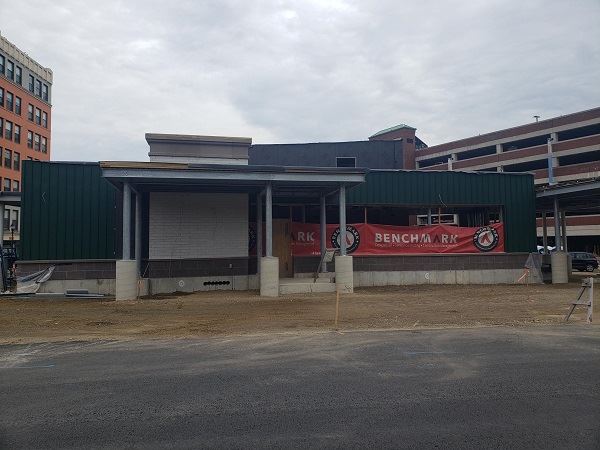

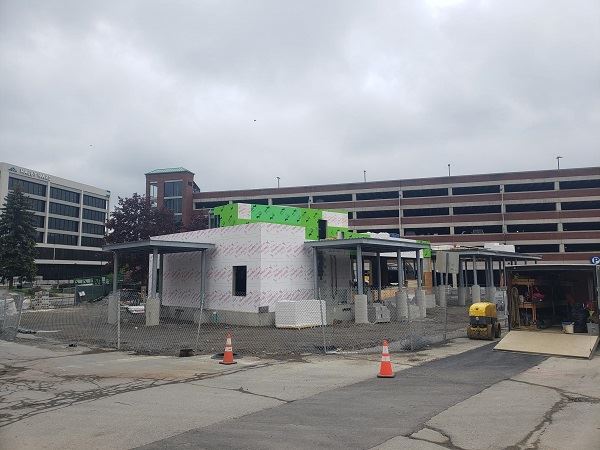

Contractors installed a large portion of siding on the outside of the Transit Center this week, with a small portion remaining.

Drywall contractors finished up sanding and prep work for interior paint.

Transit Center

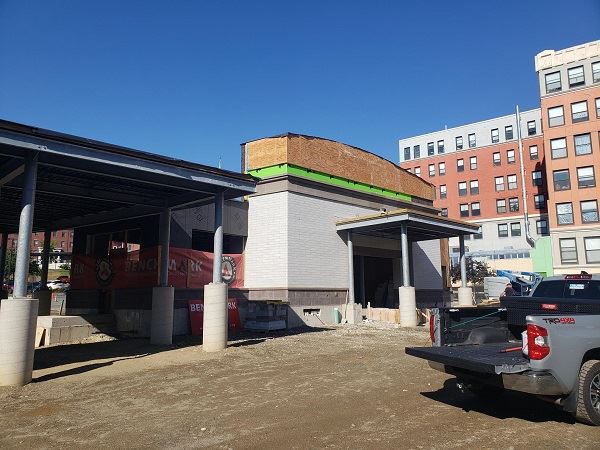

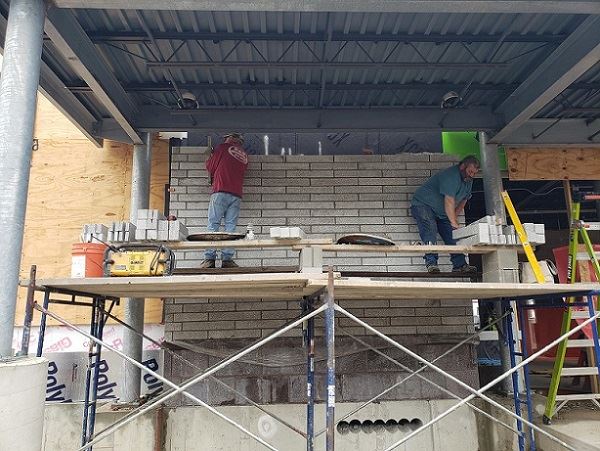

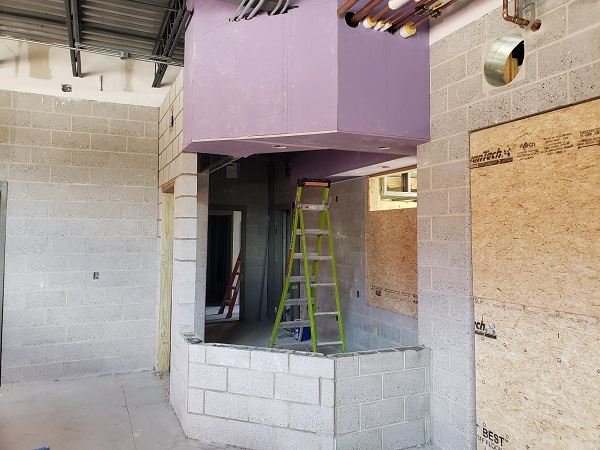

Masons installed interior brickwork for information center.

Exterior paint is being applied to the exposed steel columns on the outside of the building, as well as painting the interior offices and break room.

Groundwork is slated to continue on Monday, with granite curbing scheduled to be installed next Wednesday.

Transit Center

Friday, July 22, 2022

Transit Center

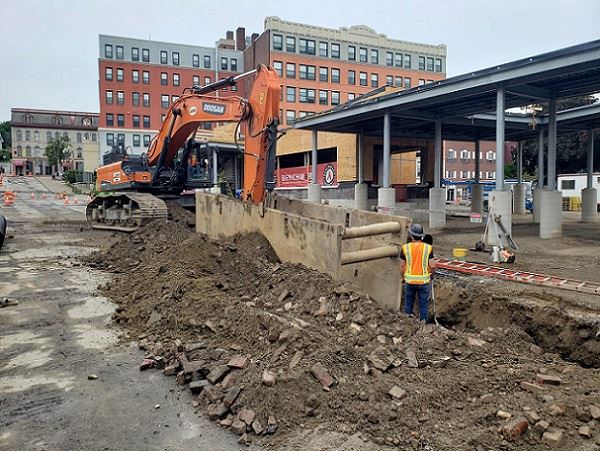

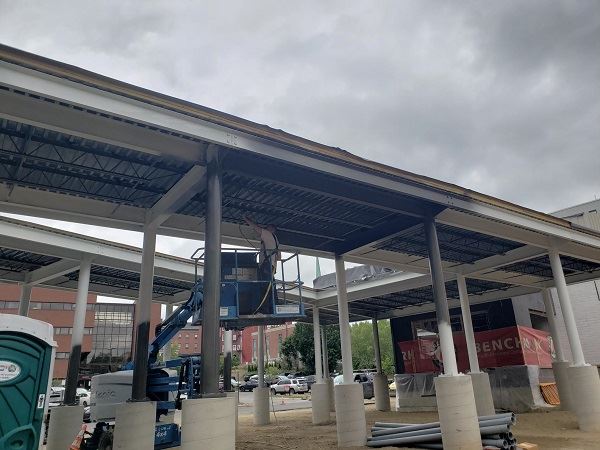

Roofers have completed a majority of the rubber roofing this week with a small portion remaining. Sheetrock is being installed inside the building along with electrical components. Groundwork is slated to begin next week around the building, laying out the road for bus parking.

Transit Center

Water Street Sewer

Eastwood completed road construction on Water Street, laying down pavement in preparation for curb installation next week. Remaining components of this job include raising catch basins, sewer manhole frames and covers and communication covers. Once complete, the final wearing course of pavement will be laid down.

Friday, July 15, 2022

Transit Center

The transit center masonry is complete and storefront window installation is scheduled to start next week, along with groundwork to begin building the road around the building.

Transit Center

The Water Street sewer replacement project has all of the underground utilities installed, and roadwork construction has begun this week. The first course of pavement is scheduled to begin next week, followed by curb installation.

Friday, July 8, 2022

Transit Center

Work continues on the Transit Center with the majority of the brickwork being completed. Next week, door installation is scheduled to start.

Transit Center

The Water Street sewer project is coming along very well, with the completion of approximately 500 Linear Feet of storm line installed. The next phase of the job will be to prepare the road for pavement.

Friday, June 24, 2022

Transit Center: Crews continued working on masonry on the outside of the building, as well as utility installation on the inside of the building.

Transit Center

Transit Center

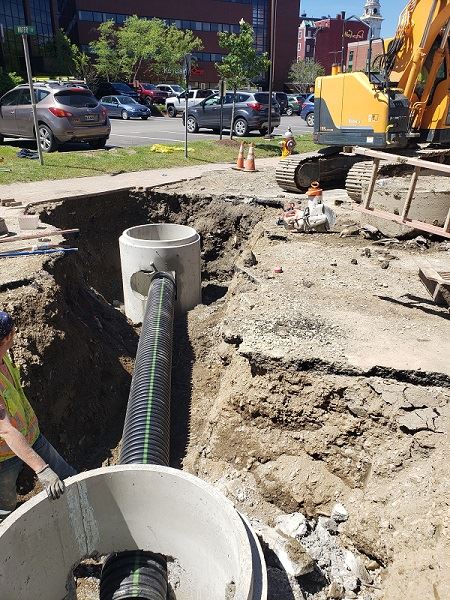

Water Street: Eastwood Contractors installed approximately 150 L.F. of 24" storm drain. They are also working with Bangor Gas to reroute a 2" gas main on Water Street.

Thursday, June 16, 2022

Work continues on the Bangor Area Transit Center, with masonry being placed on the outside of the building.

Inside the building, contractors have been installing electrical components, as well as plumbing and insulation.

The Water Street Sewer separation project continues to move forward, with approximately 500 feet of new sewer main already installed.

Eastwood Contractors are now working on the installation of stormwater drainage.

Transit Center

Transit Center

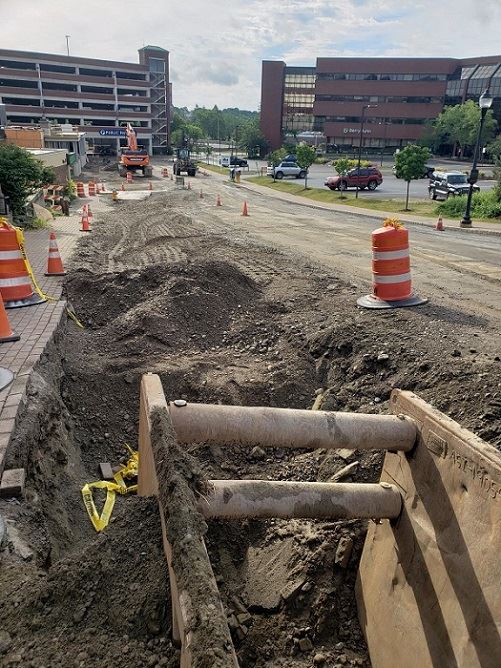

Friday, May 20, 2022

Transit Center

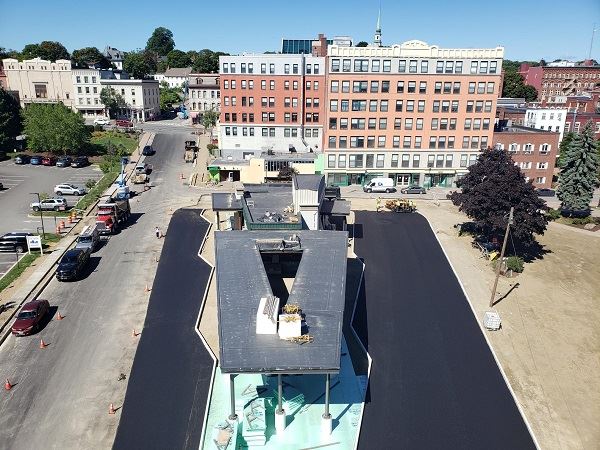

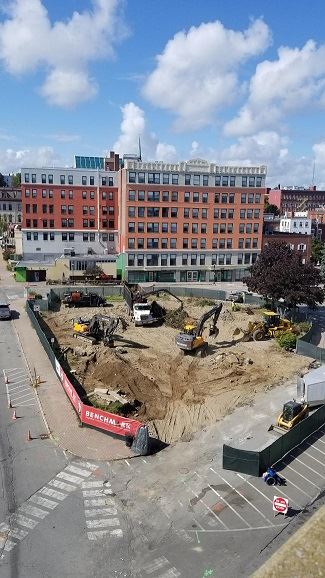

Contractors began installing roof panels and steel stud installation for interior walls. They are making good progress at this time and will continue next week.

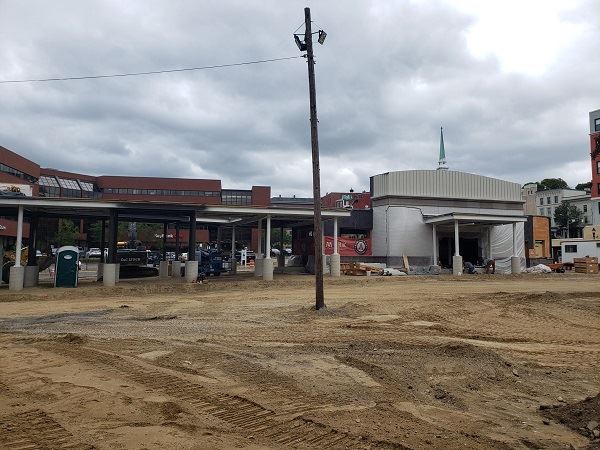

Wednesday, April 13, 2022

Transit Center

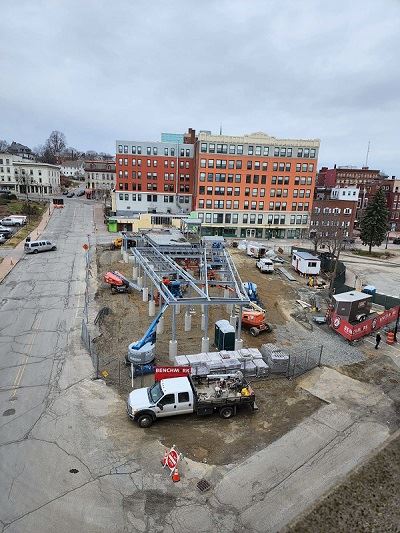

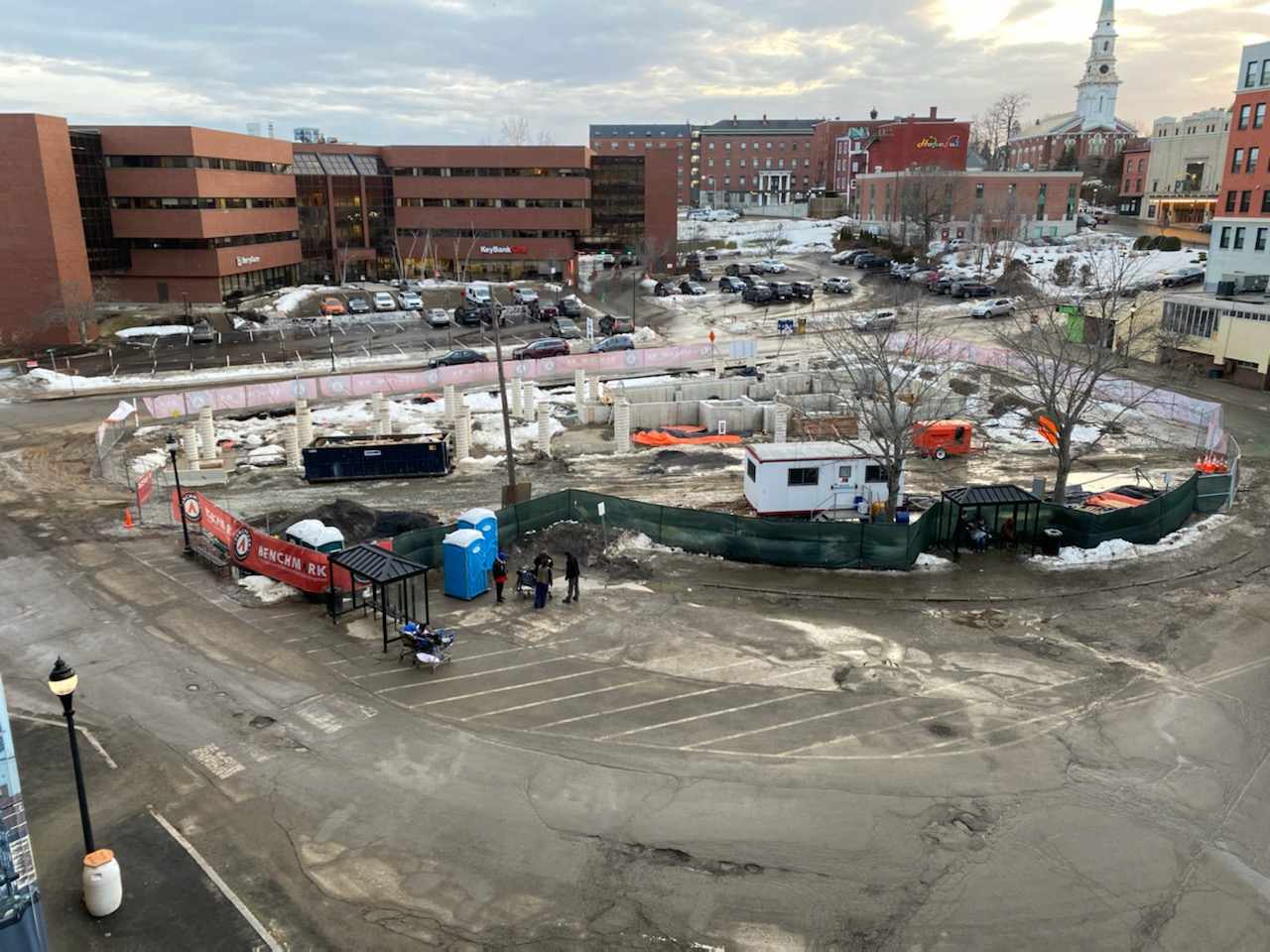

Thursday, February 17, 2022

Transit Center

Monday, February 7, 2022

Transit Center

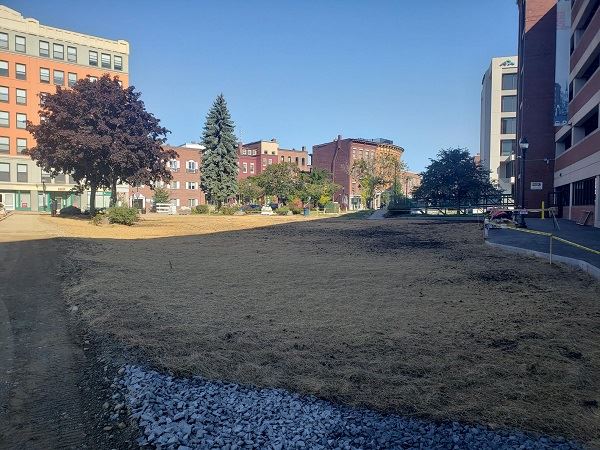

Friday, October 22, 2021

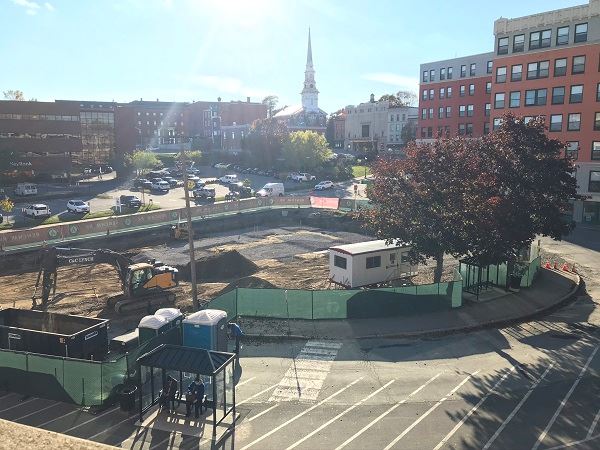

Pickering Square

Pickering Square

Pickering Square

Pickering Square

Tuesday, September 21, 2021

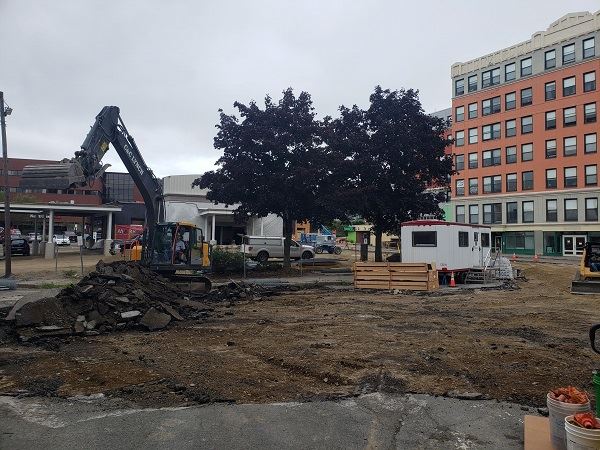

Transit CenterConstruction began this week on the Bangor Area Transit Center which is located in Pickering Square.

The proposed Transit Center is a 2,200-square-foot single-story building and includes an indoor waiting area, administrative space, public bathrooms, a bus driver's room, and a security office. The exterior of the building includes covered waiting areas, outdoor seating, lighting, and accessible passenger loading areas.

Benchmark Construction, of Westbrook, Maine was the selected Contractor to complete the project. The construction cost for the Transit Center is about $3.45 million. Funding for the project is provided through grants from the Federal Transit Administration and the Maine Department of Transportation with the City of Bangor and local Community Connector partners providing a 20% match.

The expected completion date for the project is December 2022, subject to change. The Community Connector bus service will maintain continuous operation during the construction of the new Transit Center.

On September 21, 2020, Artifex Architects & Engineers of Bangor was awarded the design contract for the Bangor Transit Center at Pickering Square. The project involves designing a new modern Transit Center building and canopy that will focus on the transit rider with amenities that improve the passenger experience.

The new facility will incorporate ADA-accessible elements that will enhance the usability and mobility of all users. The proposed amenities will include heat and air conditioning, an enclosed waiting area, outside shelters and interactive schedule information kiosks, public restrooms, a bus operators' break room, and private restrooms.

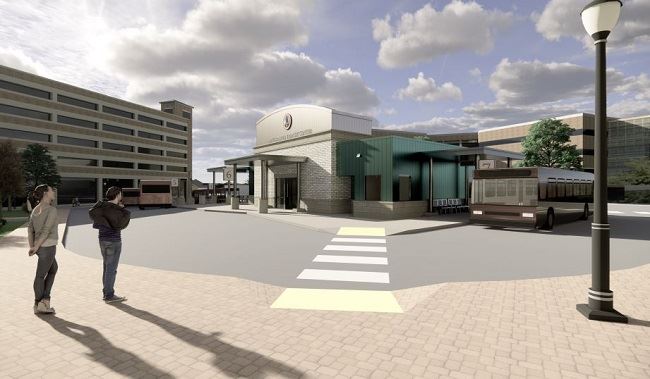

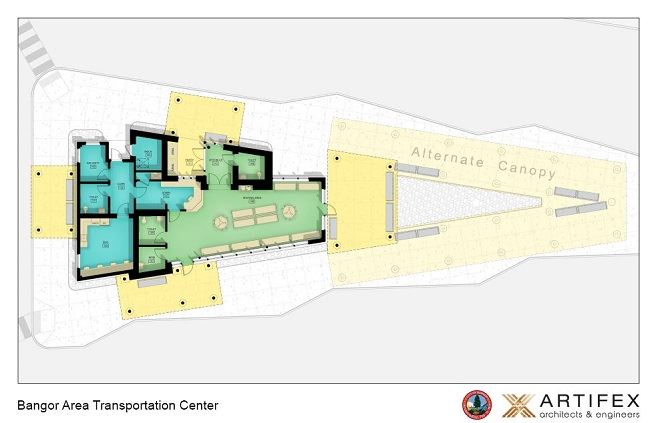

Transit Center Floor Plan

On Monday December 14, 2020 a pre-council meeting was held to review and select a concept to move forward with. The council selected the Courtyard building and canopy concept as shown in the images below. Artifex will now begin the design development stage to advance the selected conceptual design into the final design phase such that project budgets can be further refined. Once a final plan and budget is approved by council construction documents will be developed for contractor bidding.

Construction is anticipated to begin in the summer of 2021.

Updates will be provided to report on the progress of the project periodically.
